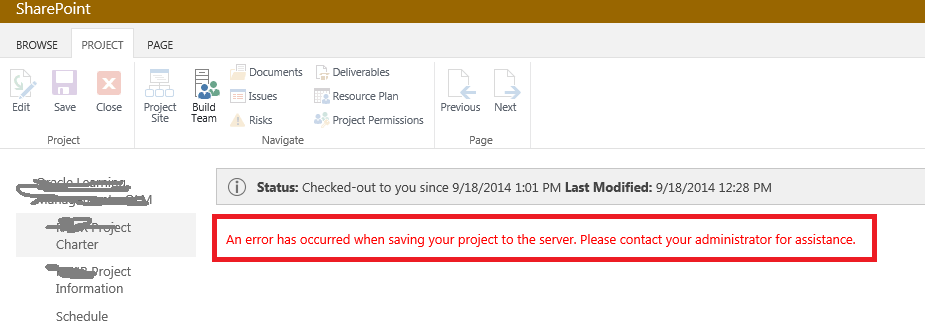

Error on Project Page in PWA:

The general error statement on PWA page is not so helpful :)



Queue Error:

You will find project stuck in queue with percentage completed less than 100%, and error details would be:

  • Microsoft.Office.Project.Server.BusinessLayer.Queue.Message:
    • ProjectPublishFailure (23000). Details: id='23000' name='ProjectPublishFailure' uid='187759d1-663f-e411-8b70-0050569b2beb' projectuid='1201772f-00b0-e311-baa9-782bcba8cb82' messagetype='Microsoft.Office.Project.Server.BusinessLayer.QueueMsg.PublishProjectMessage' messageID='16' stage='' blocking='Block'





Using JOB ID mentioned, searching ULS Log will help you find below details:

Wednesday, July 30, 2014

#ProjectServer2013 RollUp Formula field Calculation Issue #PS2013 #ProjectServer

OK this post is actually about sharing an issue i came across lately, with the hope to get a fix through any of the coming CUs. And the hope is high, with the recent news of getting scheduled CU more frequently now :)

Out of lot of improvements we are enjoying with Project Server 2013, one of them is having a scheduling capabilities built within  PWA, and now PWA schedule webpart do all the formula processing as well without open/publish the same project from Ms Project. Unlike its predecessor, where any formula field requires MS Project push to get populated, and hence we had dependency to Ms Project even in the presence of web client and it was nightmare sometimes to explain to end user that why they need to buy more Ms Projects licenses to cope up with web based client limitations.

But recently i found that 'Task level number type roll up formula field, if copied to Project level number type formula field - doesnt work' :(

Now let me try to illustrate above through an example to make it more clearer:
And before i start, note that my server is patched with SP1 (re-released) + Jul 2014 CU.

1. Create a task level number type field, lets name it: %Weight
2. Create a task level number type formula field, with roll up Sum calculation for summary rows:

           Lets name it:  %WeightedProgress = ([% Complete] * [%Weight]) / 100

Here %complete is a default field, and %Weight is the one we have created at step-1 and will be manually updated by users.

3. Create a project level number type formula field:

          Lets Name it %ProjectProgress =  %WeightedProgress

As you can see, i am only copying data of task level formula field to project level field in order to show the data in project center.

Using PWA web scheduler:

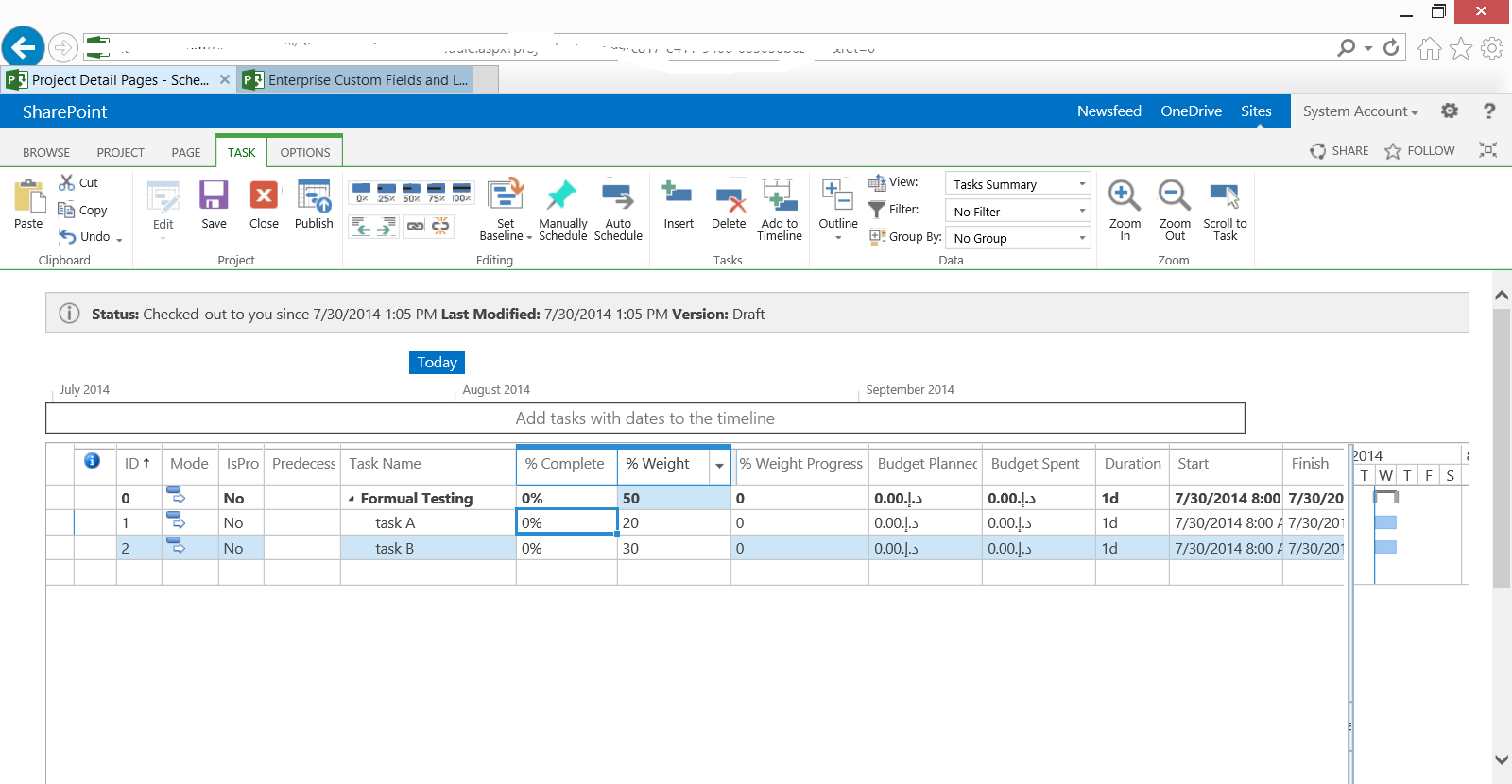

1. I have entered %Weight for following 2 tasks, %Weighted Progress is 0 for each task because %Complete is 0, and hence at project level roll up value is also 0.



2. Update %Complete of first task with 50%, and %Weighted Progress will be calculated using formula and became 10 at task level and Project roll up level. Publish project.


 3. Open Project Center and observe % Weighted Progress, its showing 0 which was the task roll up at project level before we have made any changes.



4. Open project, and update %Complete of 2nd task with 50% and that will change %Weighted Progress value to 25. Publish project.

5. Open Project Center, and observe %Weighted Progress, its showing 10 which was the task roll up at project level before we have made change to 2nd task.


By now you may have learnt that its following a unique pattern while updating project level custom field. That its showing you previous value at project center level once you publish your project, although at Project level it updates at the same time.

So the first time when at Project level it was 0, in Project Center it was appearing blank.
Second time when at Project level it was 10, in Project Center it was appearing 0.
Third time when at Project level it was 25, in Project Center it was appearing 10.

Lets update our project plan one more time to assure our conclusion.

6. Open project, and update %Complete of Task A with 100% and that will change %Weighted Progress value to 35. Publish project.


7. Open Project Center, and observe %Weighted Progress, its showing 25 which was the task roll up at project level before we have made change to Task A.



So Fourth time when at Project level it was 35, in Project Center it was appearing 25.

I hope an issue is clear, now a workaround to this is to open/publish using Ms Project and everything will work like a charm, just like old times (Project Server 2010).

Though its not workable in my current scenario because not all the end user have Ms Project on their PCs.

With the hope that we get fix to this issue soon :), see ya next time.

Tuesday, April 29, 2014

#ProjectServer and #SharePoint 2013 SP1 re-released #ps2013 #sp2013 #office2013

There is lot of noise over the web related to Service Pack 1 of MS Office 2013 products, it was released with much of an applaud then deactivated due to issue and then re-released with lot of clarifications :) because in between deactivation and re-release of SP1, April 2014 CU for Project Server and SharePoint 2013 was also released.

So let me kill all this unnecessary noise with the final announcement that Service Pack 1 is now available to download, and all the clarifications in a nut shell is that Just apply this SP1 to your environment even if you have applied the previously released SP, and also feel free to apply this SP1 if you have April 2014 CU in place.  don't forget to  run the configuration wizard in the end :)

Also do not forget that unlike old times, this SP1 is not a roll up package, which mean you should install SharePoint 2013 SP1 + Project Server 2013 SP1 and then run the configuration wizard in the end.

Download links for updated SP1:

For details please see Brian Smith post, you can find details of almost all the queries in your mind on his blog post.

Also see Stefan Bogner's post for details related to Service Pack 1 release announcement and clarifications.

As always try any patches in your test environment prior to apply to production.

Happy patching :D

Thursday, April 10, 2014

#Project, #ProjectServer and #SharePoint Server 2013/2010 April 2014 CU available #ps2013 #sp2013

This is to announce that April 2014 CU of Project, Project Server and SharePoint Server 2013/2010 is out now. The important point to note that April 2014 CU of Project Server 2013 includes the fixes of SP1 as well. Since SP1 is deactivated until further announcement from Microsoft, Apr 2014 CU can do the job for now.

Also Project Server 2013 CU is not a roll-up package, which means it doesn't includes SharePoint server fixes.

Test the CU in your test environment first prior to apply to production.

Project Server 2013 individual Apr 2014 CU: http://support.microsoft.com/kb/2863881
Project 2013 Apr 2014 CU: http://support.microsoft.com/kb/2878276
SharePoint Server 2013 Apr 2014 CU: http://support.microsoft.com/kb/2768332

Project Server 2010 individual Apr 2014 CU:http://support.microsoft.com/kb/2878259
Project 2010 Apr 2014 CU: http://support.microsoft.com/kb/2878263

For more details please see: http://blogs.technet.com/b/projectsupport/archive/2014/04/09/microsoft-project-server-2010-and-2013-april-2014-cu-announcement.aspx



Tuesday, April 8, 2014

#SharePoint Product Configuration Wizard Error: Unable to create a Service Connection Point in AD #SP2010 #PS2010

While updating one of my Project Server 2010 environment with language pack, the configuration wizard has thrown following error in the end at step 9:


An exception of type Microsoft.SharePoint.PostSetupConfiguration.PostSetupConfig
urationTaskException was thrown.  Additional exception information: The upgrade
command is invalid or a failure has been encountered.
Failed to upgrade SharePoint Products.

ULS logs digging helped me found a substantial clue and reminded me that i did come across to similar issue long time back as well. The issue is related to configuration to track any SharePoint production installation to farm of your organization, and tracking requires container in AD with appropriate user permissions to allow installation. If the account does not have permission to write to this container, the following warning will appear in the log file for the SharePoint Products Configuration Wizard and Wizard will fail at the last step:



Failed to add the service connection point for this farm
Unable to create a Service Connection Point in the current Active Directory domain. Verify that the SharePoint container exists in the current domain and that you have rights to write to it.”
To resolve this follow these steps:
  1. On the domain controller, click Start, point to Administrative Tools, and then click ADSI Edit, or use a remote administration tool to connect to ADSI Edit from another computer.
  2. On the Action menu, click Connect to, and connect to the domain that you want to use.
  3. In the console tree, expand the connection, expand the domain name, and then click CN=System.
  4. In the details pane, right-click in the white area, click New, and then click Object.
  5. In the Create Object dialog box, in the Select a class box, click container and then click Next.
  6. In the Value box, type Microsoft SharePoint Products as the container name, and then click Next.
  7. Click Finish.
    The container is created.
  8. Right click the container (CN=Microsoft SharePoint Products), and then click Properties.
  9. On the Security tab, click Add.
  10. In the Select Users, Computers, Service Accounts, or Groups box, add the users that you want to write to this container, and then click OK.
    Note that if a user who cannot write to this container installs SharePoint Server 2010, no new entry will be created. Consider giving all Authenticated Users the permission so that you can track all the objects.
  11. In the Group or user names box, select the names that you previously added, and then under the Permissions box, clickAdvanced.
  12. In the Permission entries box, select the names that you previously added, and then click Edit.
  13. In the Permission Entry for Microsoft SharePoint Products dialog box, in the Permissions box, select the Allow check box forCreate serviceConnectionPoint objects, and then click OK.
Now re-run the wizard and hopefully this time it will go through successfully.
The whole process, with powershell comands as well, can be found here: http://technet.microsoft.com/en-us/library/ff730261.aspx
Happy updating SharePoint farm :)

Share
